(I)ORDER4 min read

Start with the order

Meet the shop we'll follow through this guide: Nebula Aerospace, an that builds satellites. One customer, NovaSat Networks, just placed an order for 90 solar array wings. By the end, you'll have followed that order all the way from the sales desk to 90 finished wings on the shipping dock — and seen most of Carbon along the way.

Carbon spans the office and the floor: ERP for orders, purchasing, and planning; MES for the people actually building. The thread that ties them together is a single order, so that's where we start.

The path one order travels through Carbon, and the shape of this guide.

The sales order

Open the dashboard. There's already an order on the books: SO000009, 90 SAW-001 Solar Array Wings at $35,000 each. But the customer doesn't want all 90 at once, so the order carries three lines of 30 — one this week, one next week, one the week after. That delivery schedule is going to shape everything downstream.

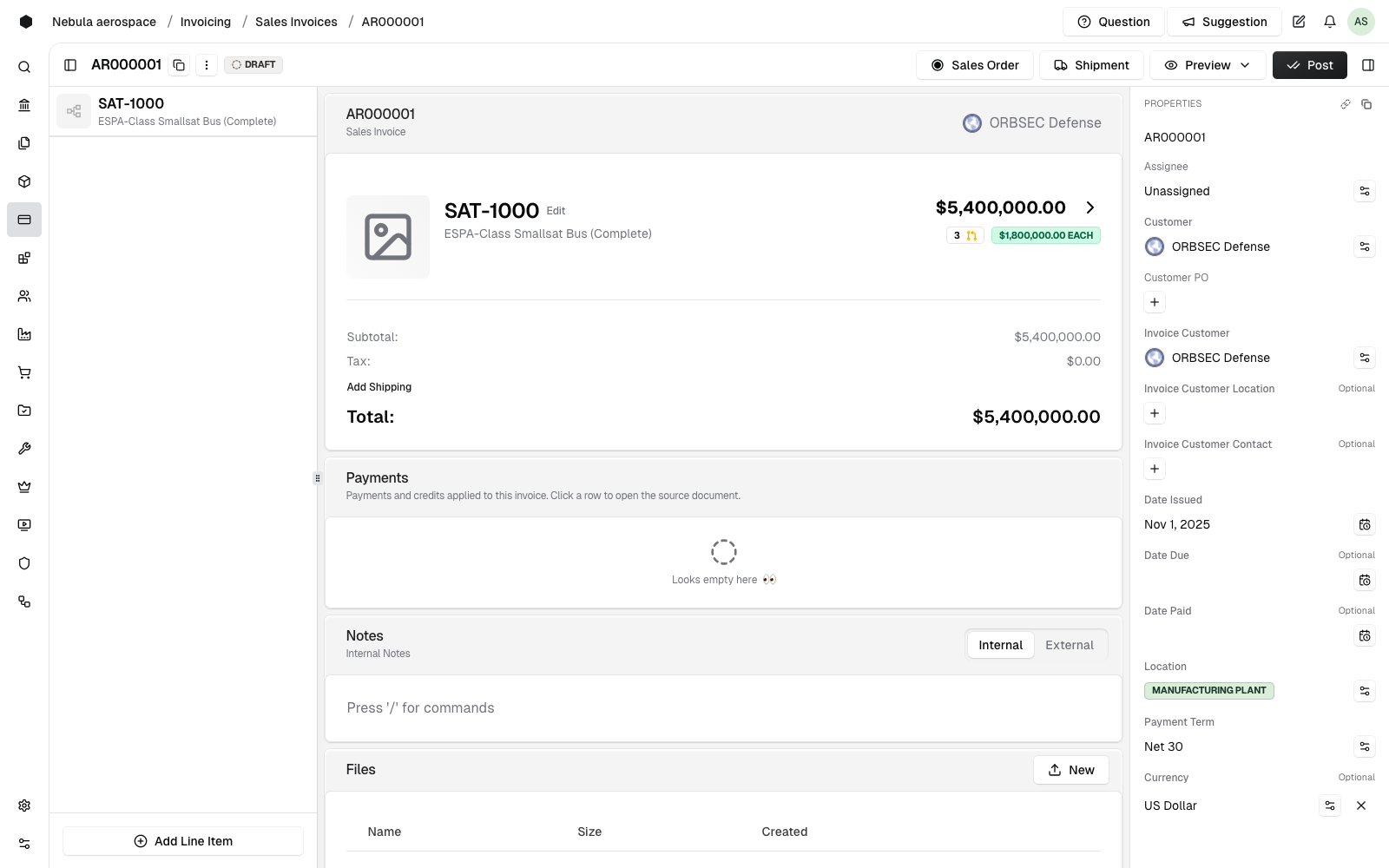

Shipping part of an order doesn't close it. The badge on the header reads "In Progress", the display status Carbon shows while the order's make-to-order lines still have production to finish; the stored status underneath is "To Ship and Invoice" while any unit has yet to ship. Once every unit has shipped but you haven't billed yet, it moves to "To Invoice". The order closes only when everything has both shipped and been invoiced. That's what lets one order be fulfilled in batches without losing track of what's left.

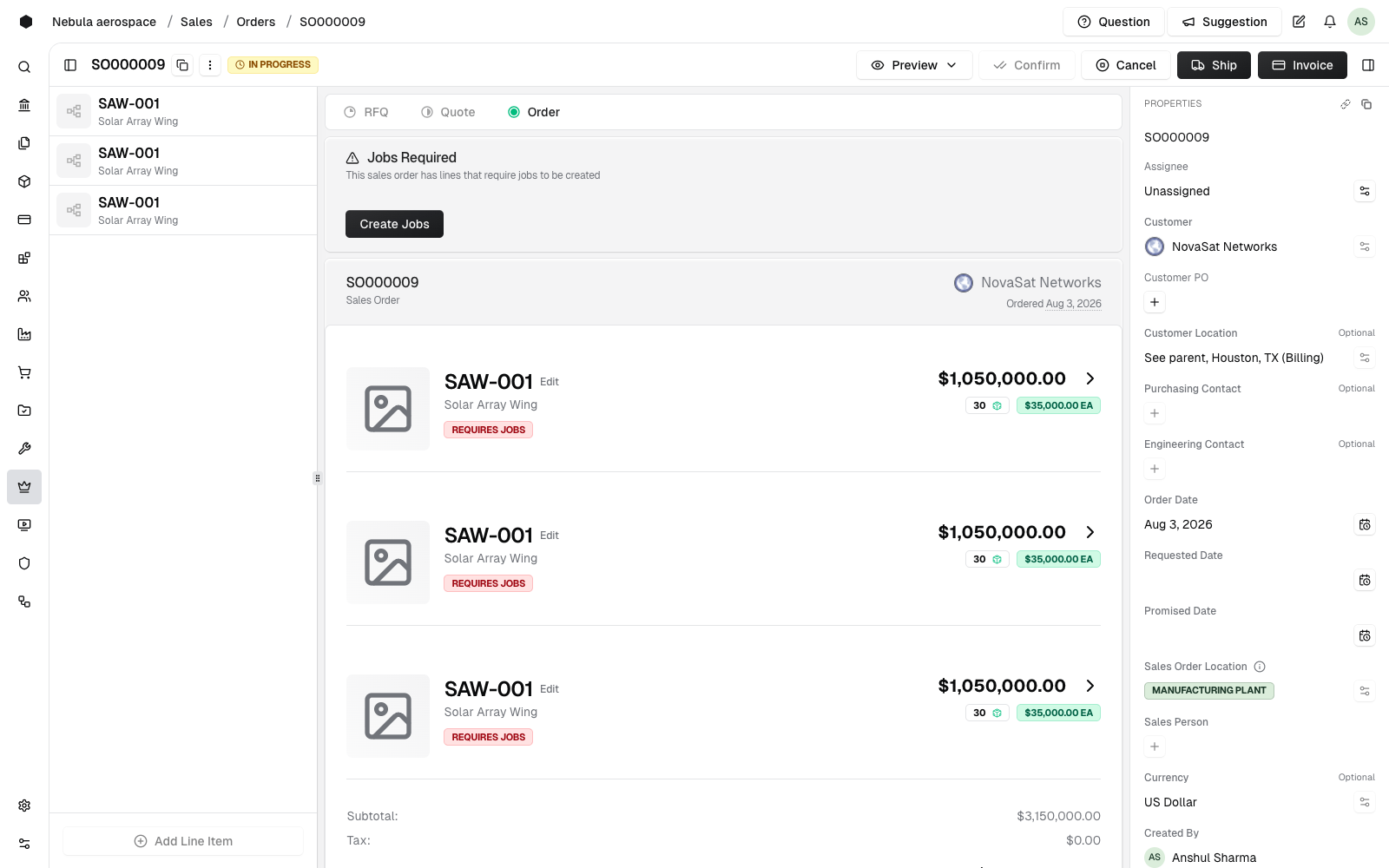

SO000009 for NovaSat Networks: three lines of 30 Solar Array Wings, an 'In Progress' badge, and a 'Jobs Required' banner waiting on you to create the jobs.
UPSTREAM

The order often starts as a quote.

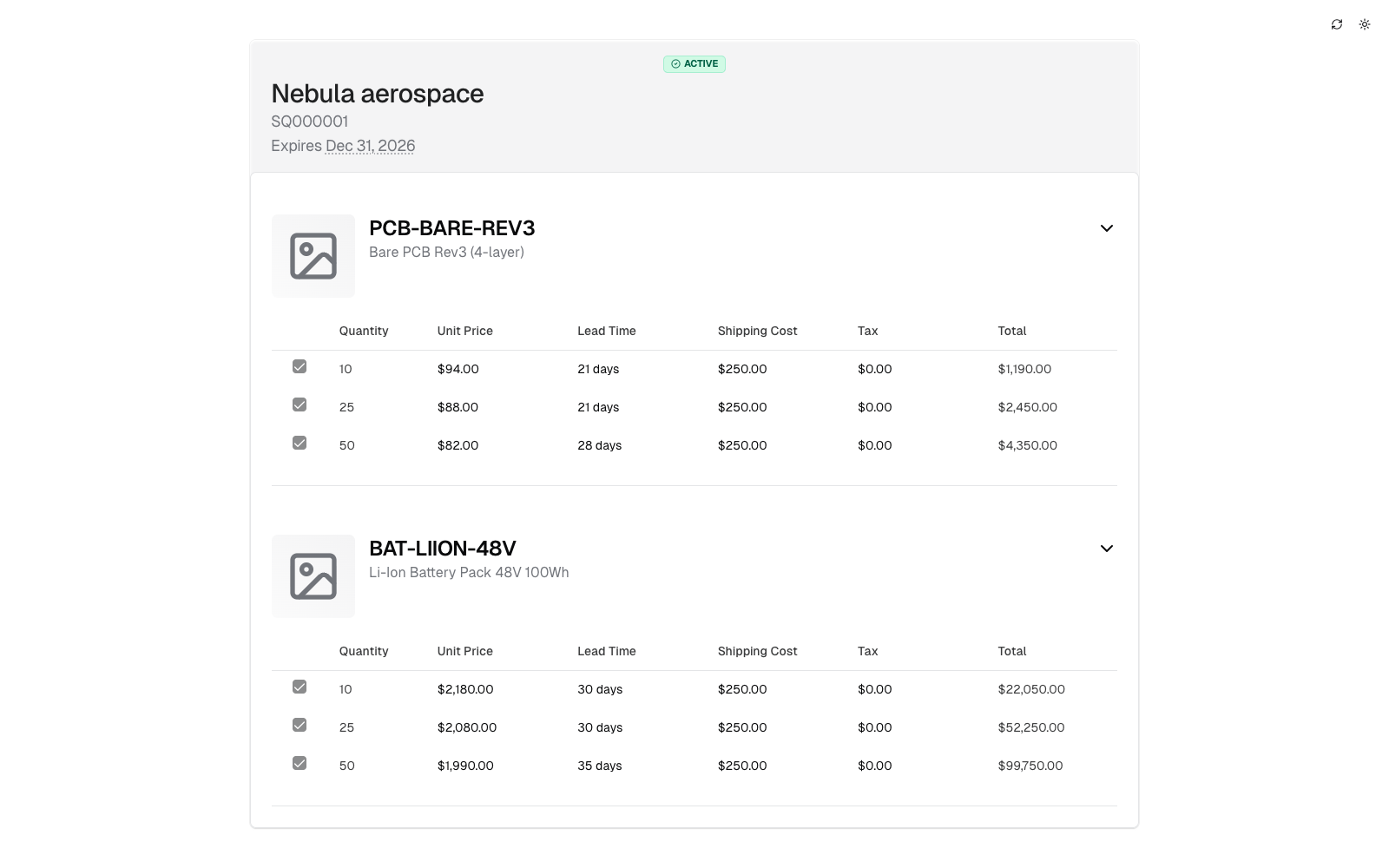

Carbon has a full module with quantity-break pricing, so the 90-unit price could have been negotiated in first. We'll pick the story up at the confirmed sales order, where the build truly begins.

Batch it into jobs

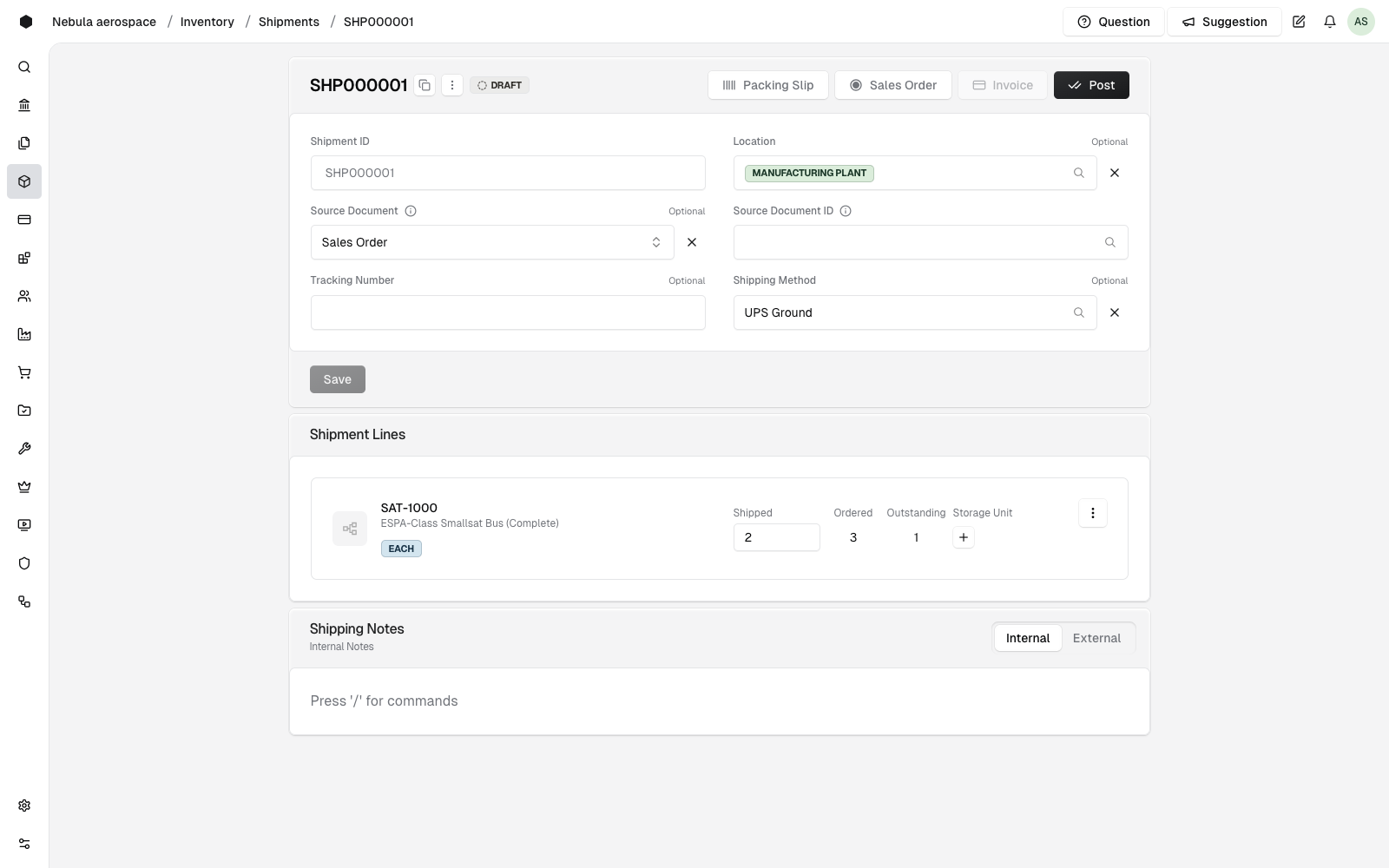

You don't build 90 wings as one monolithic job. To match the three-week delivery schedule, the order's three lines of 30 become three of 30, one per delivery, each scheduled, released, and shipped on its own timeline.

You create those jobs from the sales order itself. The "Jobs Required" banner at the top of the order is the prompt; its "Create Jobs" button covers the whole order at once. To do it line by line, use the line's Jobs card: click "Make to Order" and the "Convert Line to Job" dialog opens with the Quantity already prefilled at the line's 30. Create the first job, then repeat for the second and third lines. Carbon counts down the units still waiting on a job (90 → 60 → 30), so you always know how much of the order is left to batch. To build only part of a line, lower the prefilled Quantity and convert the remainder later.

One 90-unit order, batched into three 30-unit jobs across three weeks.
Where you batch: the line's Jobs card. 'Make to Order' opens 'Convert Line to Job' with the Quantity prefilled at the line's 30. Create each batch, repeating until the order is fully covered.
WHY BATCH

Batching matches your build to the delivery promise.

Three jobs of 30 let you release week one now, keep weeks two and three in planning, and ship each batch the moment it's done — instead of waiting on all 90.

Create the job

From the sales order, create the job. Carbon carries the part, quantity, and due date across automatically. The job inherits exactly what was sold. That way, the shop floor always has the up-to-date specifications and requirements for the job.

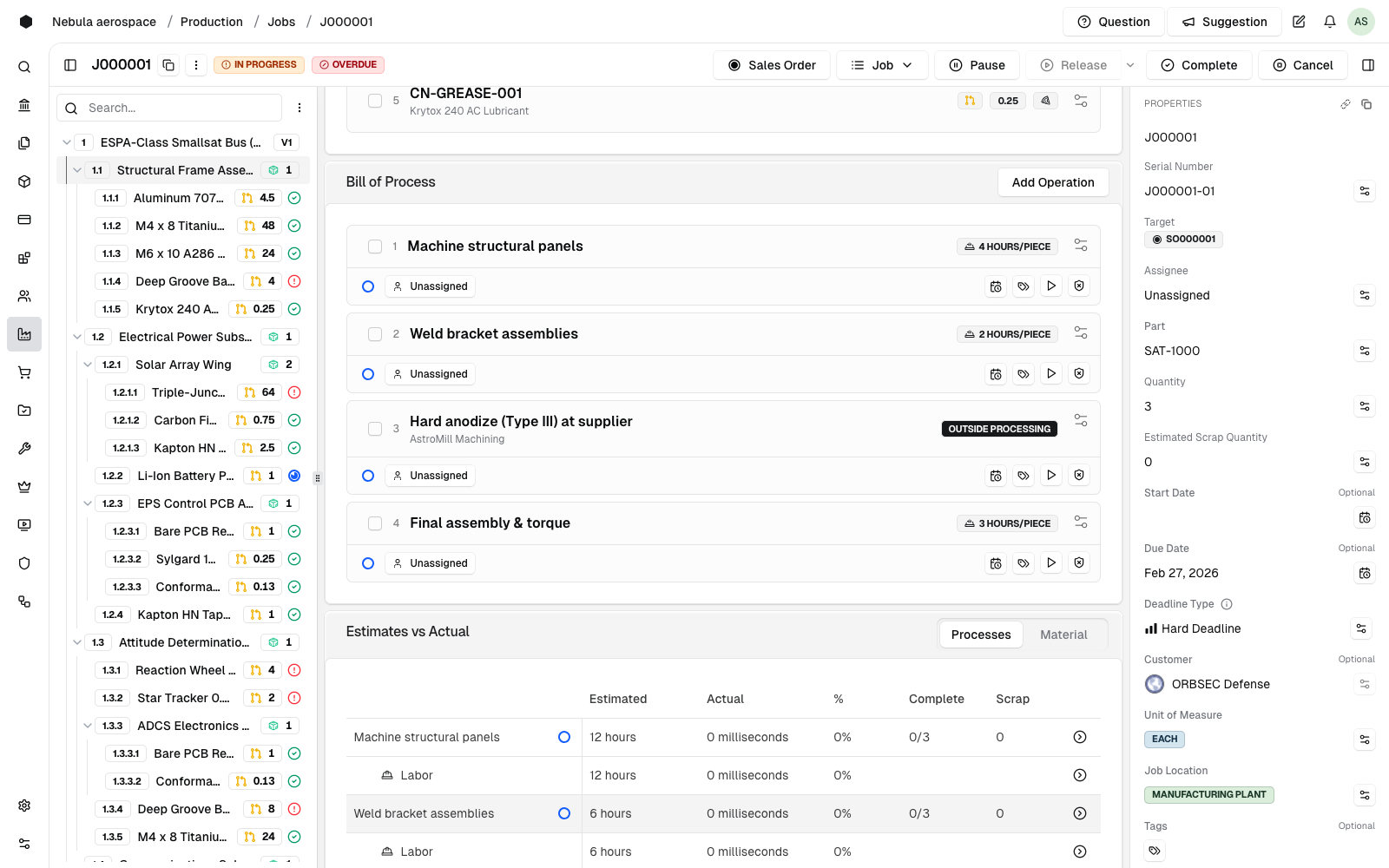

Carbon carries one more thing across, and it's the most important: the part's , its full recipe of materials and operations. The job doesn't point at the part's master recipe, though. It gets its own copy.

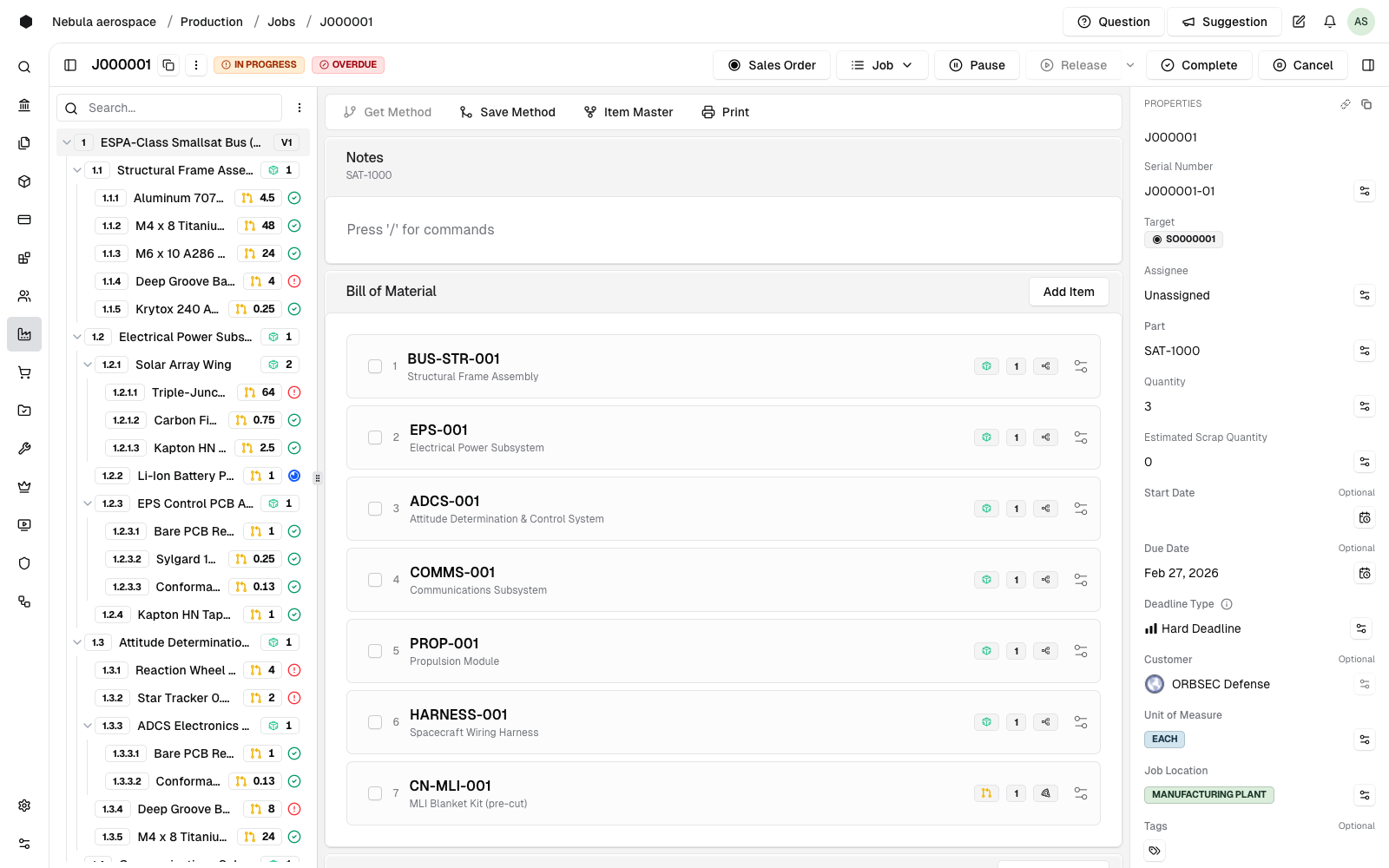

A job created this way — here J000001 for the SAT-1000 satellite bus — carries its own copy of the part's method, with part, quantity, and due date inherited from the sales order line.

Get the method

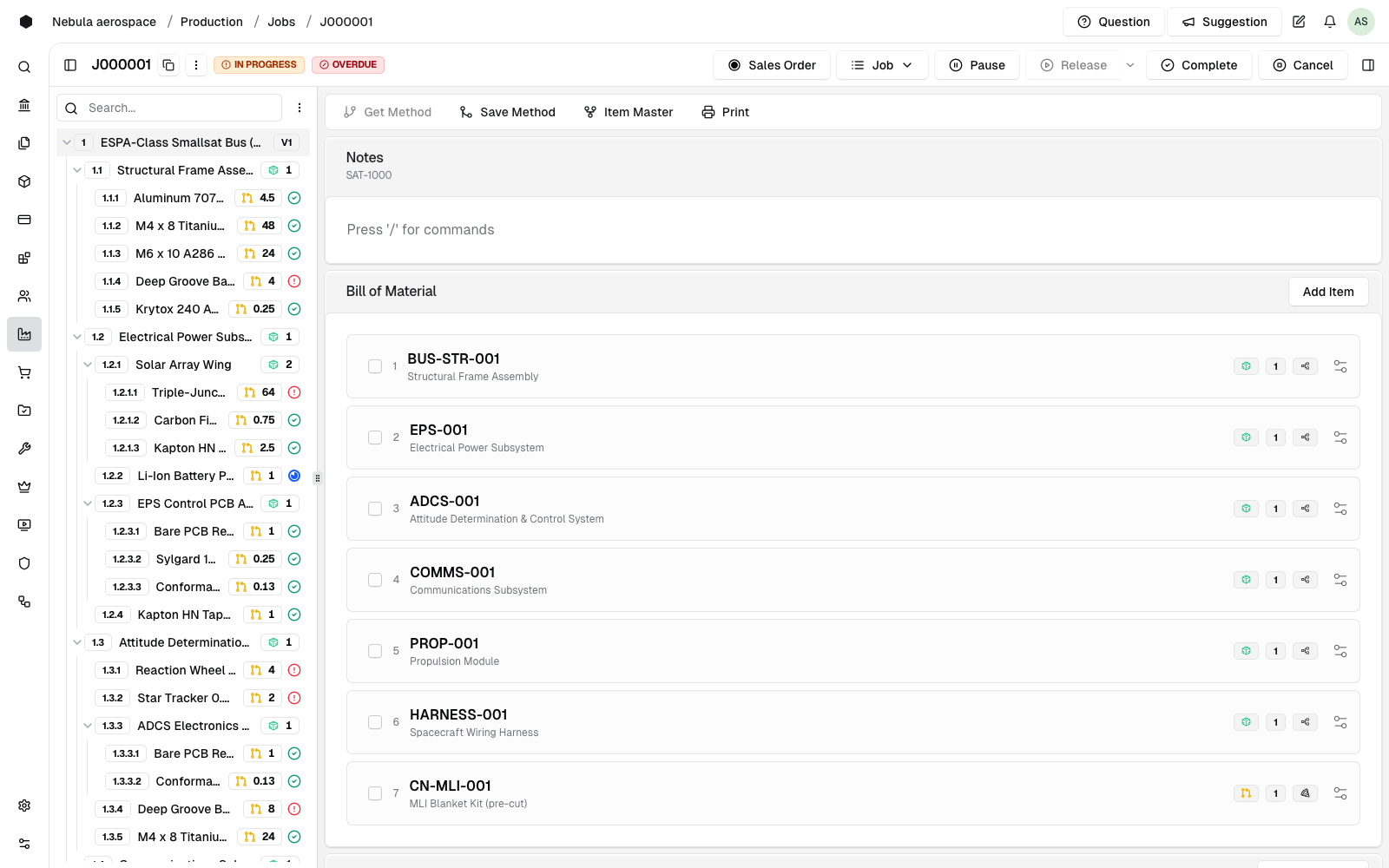

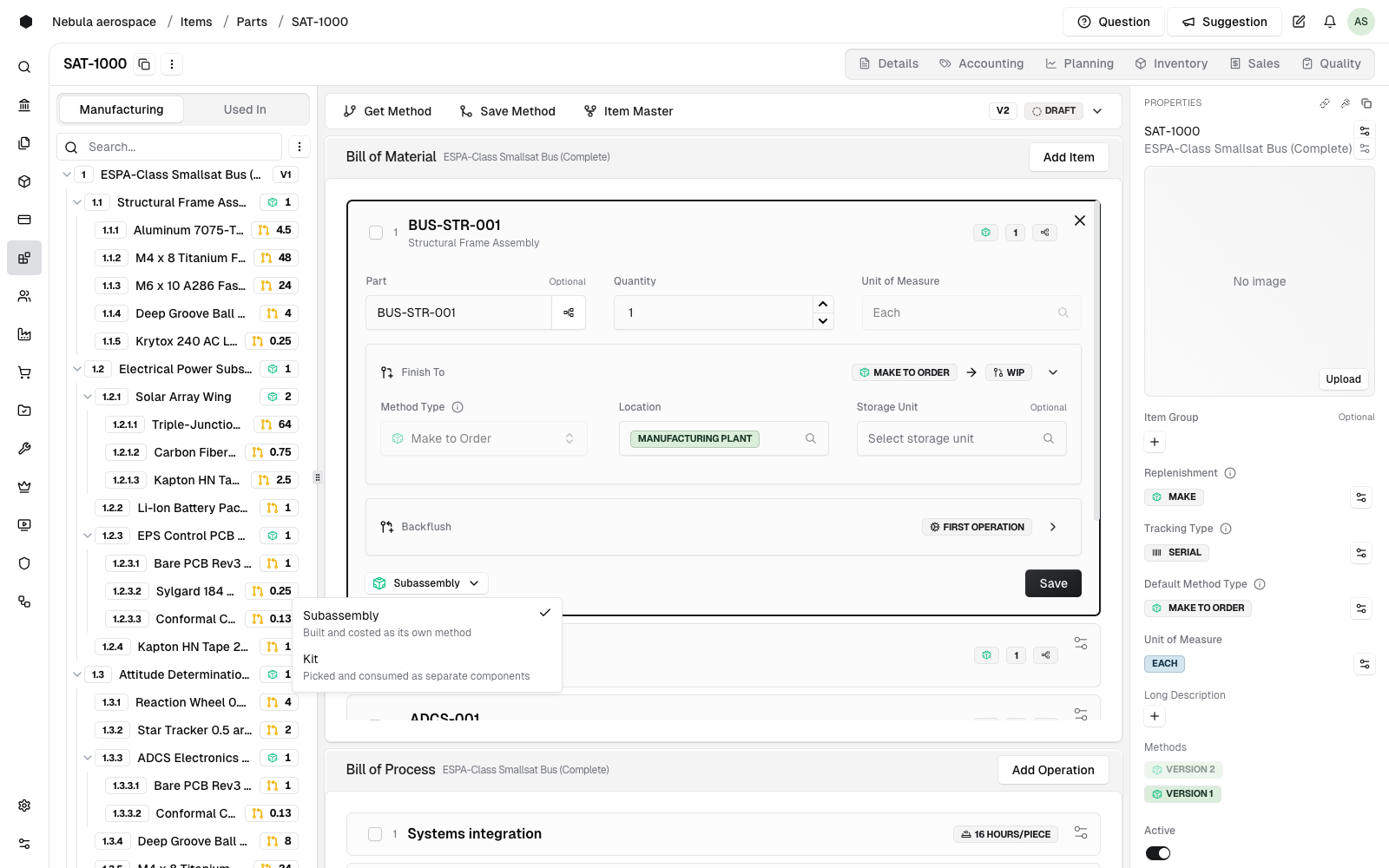

Pulling that recipe into the job is an explicit action in Carbon called . It clones the part's method, every material and every operation, into a job-specific method that belongs to this job alone.

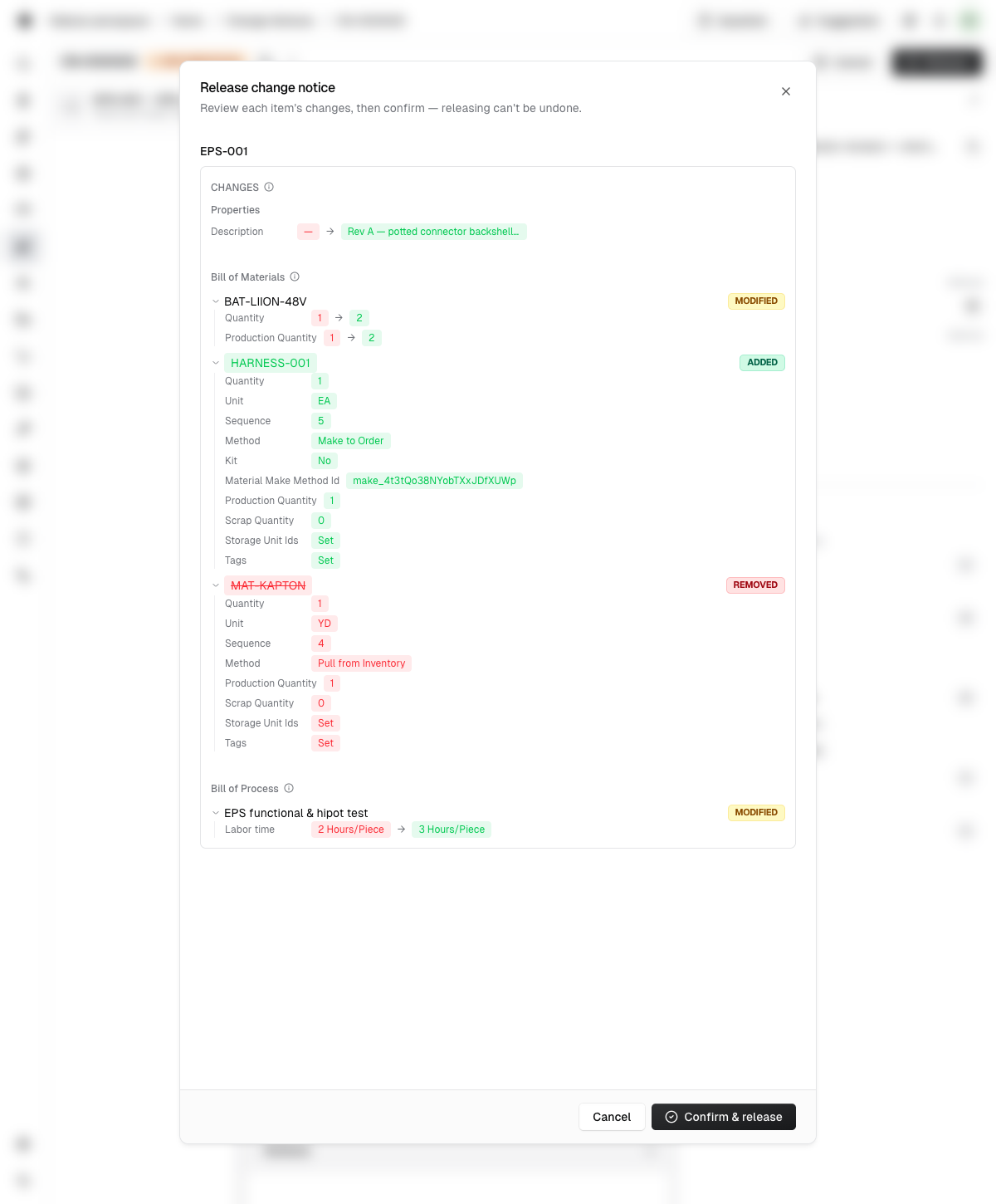

That copy is the whole point. Say this batch needs a one-off substitution, like a different fastener or an extra inspection step. You edit the job's method, and the part master stays untouched. And when a change proves itself, you can push it back up to the part so every future job inherits it.

Get Method copies the part's recipe into the job. Edits stay local until you push a proven change back up.
GET METHOD

The part holds the master recipe; the job holds a working copy.

Editing a job never silently rewrites your part library, and updating a part never disturbs a job already in flight. Nothing flows between them automatically: you copy the recipe down when the job is created, and push improvements back up only when you choose to.

Release or plan

Now the key decision. You'll release one job, week one, and leave the other two in planning. The difference is what each action sets in motion:

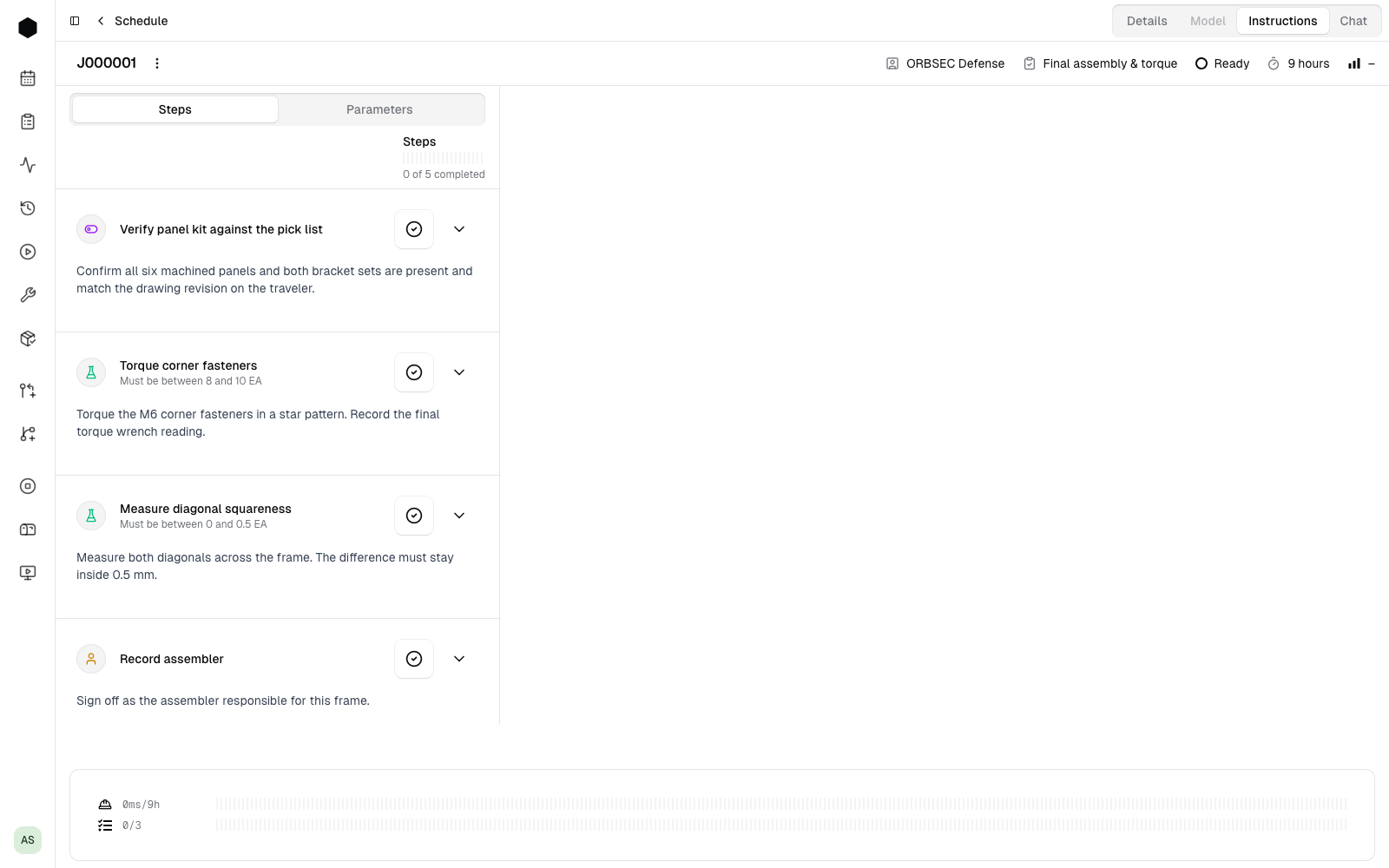

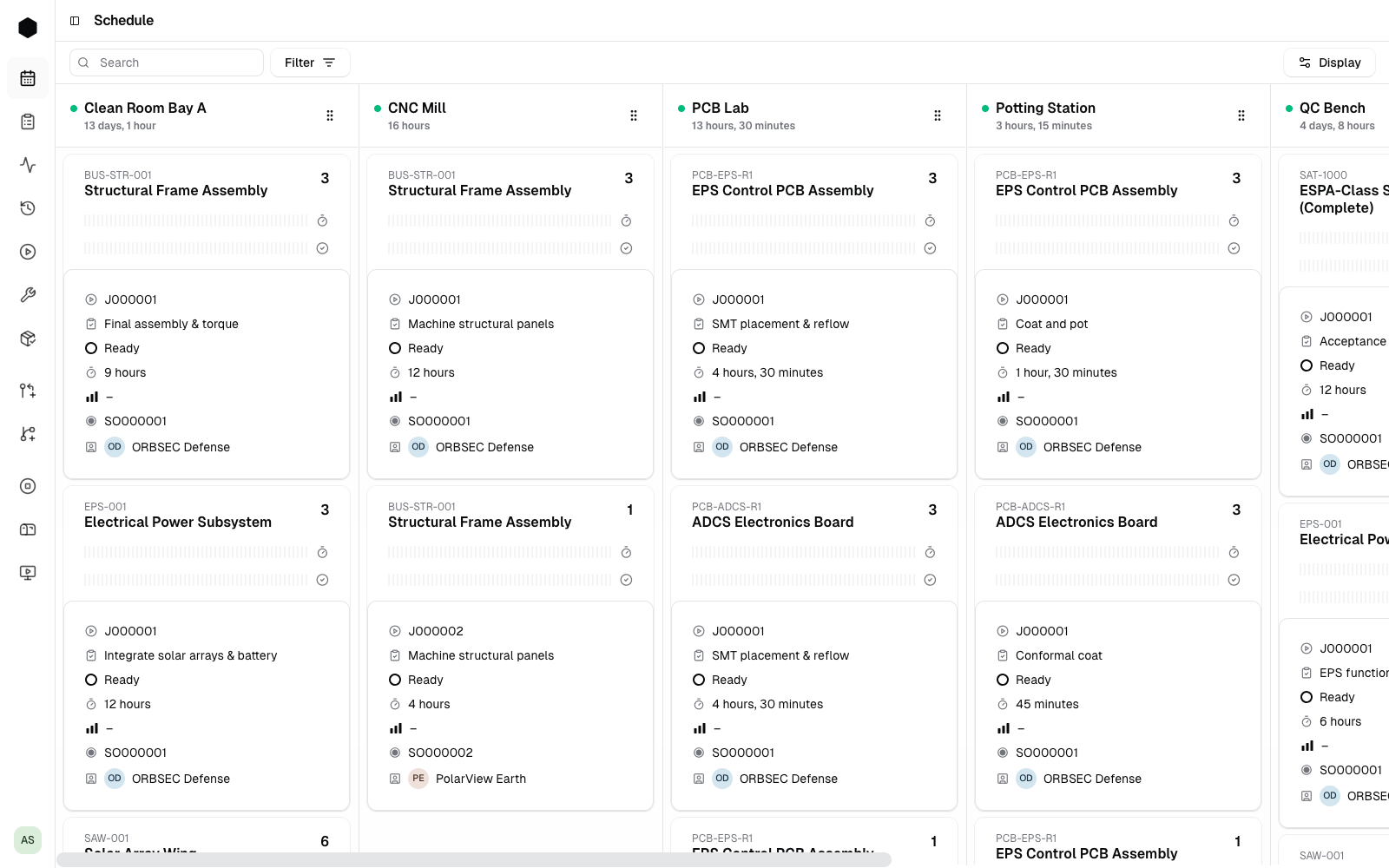

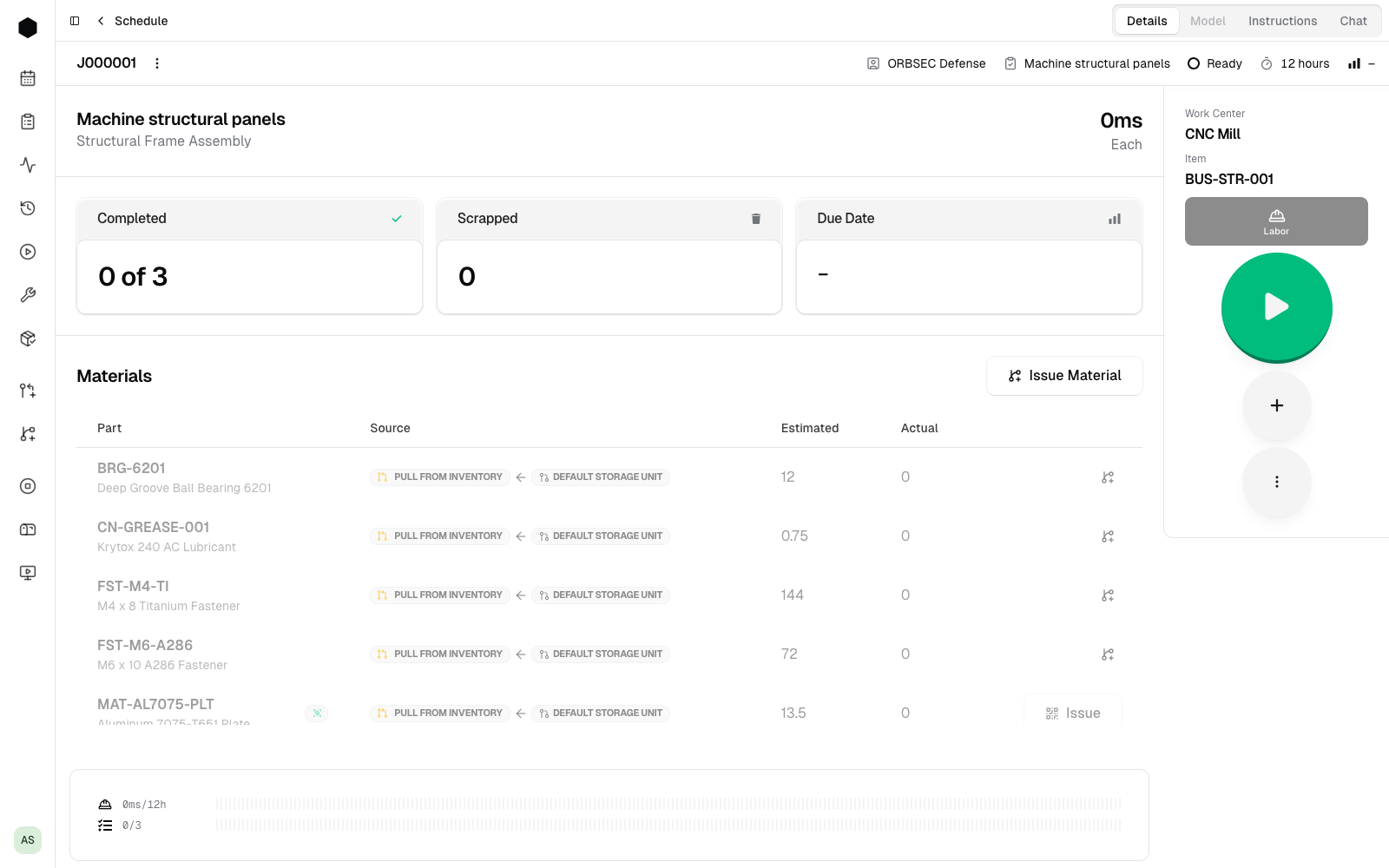

  • Release: generates inventory alerts for any required material that isn't in stock, and adds the job's tasks to the shop-floor schedule. This is work the floor can start.

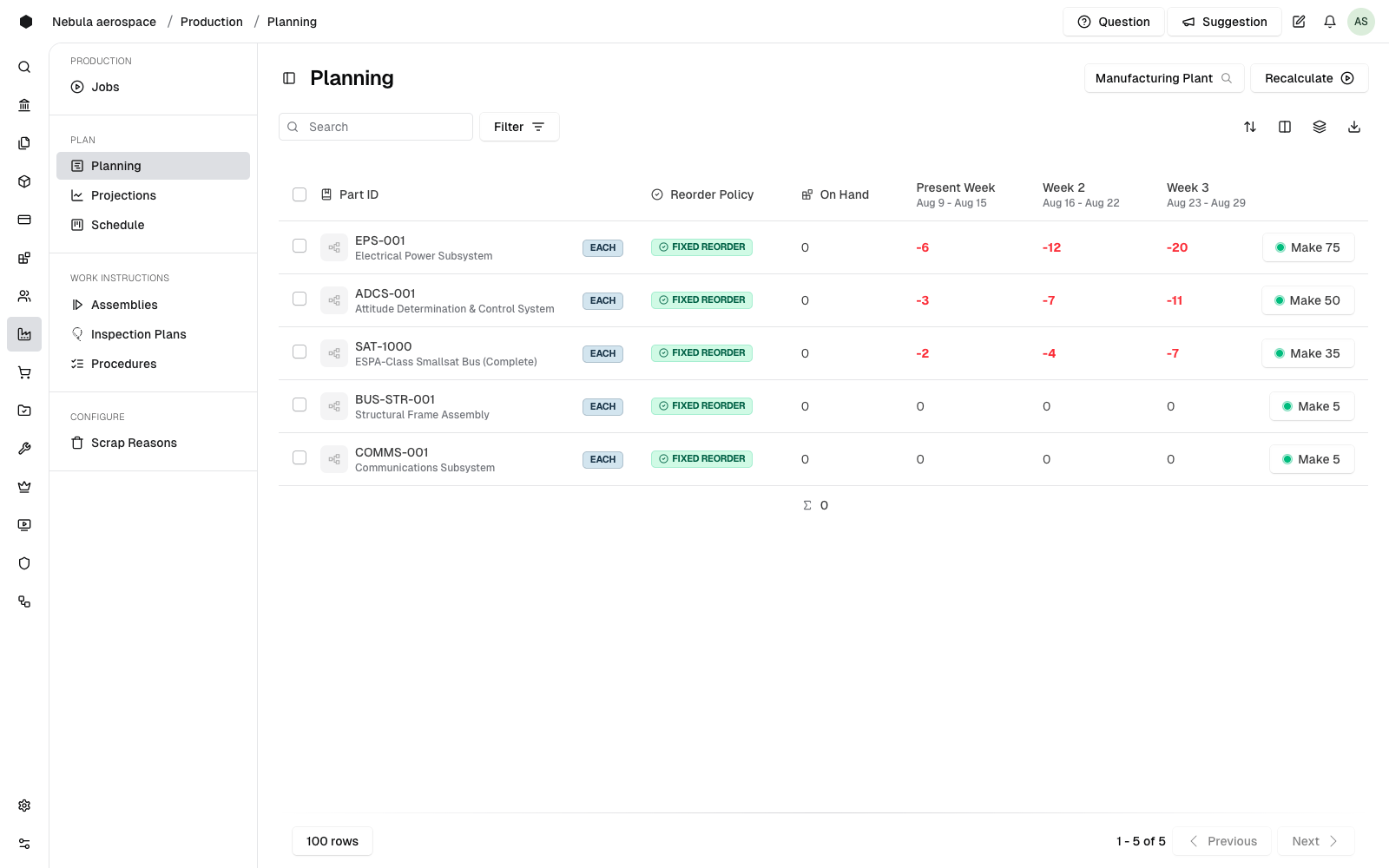

  • Plan: generates the same inventory alerts, but does not schedule anything. It's how you see what a future job will need without the shop floor seeing it on the schedule. They are not yet notified about this job in any way.
RELEASE ≠ PLAN

Plan = See demand early | Release = Put work in motion

Planning weeks two and three now means you can order materials that have a long lead time — without cluttering this week's schedule with jobs the floor can't touch yet.
